The Anonymous Widower

Thoughts On The Lateness Of Crossrail

This article on the BBC is entitled Crossrail Delay: New London Line Will Open In Autumn 2019.

This is the first paragraph.

London’s £15bn Crossrail project is to open nine months after its scheduled launch to allow more time for testing.

I spent most of my working life, writing software for the planning and costing of large projects and despite never having done any serious project management in anger, I have talked to many who have, both in the UK and around the world.

So what are my thoughts?

Crossrail Is A Highly-Complex Project

The project involves the following.

  • A 21 km double-track tunnel under London.
  • New Class 345 trains
  • Four different signalling systems.
  • Rebuilt stations at West Drayton, Hayes & Harlington, Southall, West Ealing, Ealing Broadway. Acton Main Line, Forest Gate, Manor Park, Ilford
  • Refurbished stations at Hanwell, Maryland, Seven Kings, Goodmayes, Chadwell Heath, Romford, Gidea Park, Harold Wood, Brentford and Shenfield.
  • Major interchanges with existing stations at Paddington, Bond Street, Tottenham Court Road, Farrington, Liverpool Street, Whitechapel and Stratford.
  • New stations at Custom House, Canary Whar, Woolwich and Abbey Wood.

Some parts are easy, but a lot are very difficult.

A Shortage Of Specialist Workers

I believe that certain factors could be reducing the pool of workers available to Crossrail.

Less workers than needed would obviously slow the project.

Having to pay more than budgeted to attract or keep workers will also raise costs.

My thoughts on what is causing a possible shortage of specialist workers follow.

Crossrail-Related Development

If you own a site or a building, near to one of Crossrail’s stations, then your property will substantially increase in value, when the line opens.

Walk past any of the Crossrail stations in Central London and some further out and you will see towers sprouting around the station entrance like crows around a road-kill.

Developers know how to cash-in on the best thing that has happened to them since the Nazis flattened acres of Central London.

New sites are also being created over several Crossrail stations including Moorgate, Farringdon (2 sites), Tottenham Court Road (2 sites), Bond Street (2 sites) and Paddington.

But do all these extensive developments, mean that there are not enough sub-contractors, specialist suppliers, electricians, chippies, air-conditioning engineers, plumbers and other trades to do all the work available in London?

I also suspect a developer, building an office block to the world’s highest standard could pay better and faster, than a Crossrail supplier under pressure.

Underground Working

Working underground or in mining is dangerous.

In the 1960s, women were totally banned from working below the surface.

It must have been around 1970, when I met one of ICI’s archivists; Janet Gornall, who a few years previously had organised storage of their masses of historical documents, in the company salt mine at Winsford. The mine is still used for document storage, by a company called Deepstore.

Health & Safety found out that Janet would be supervising and indexing the storage underground, so that if any document was required, they could be easily retrieved. This caused them to give the scheme a big thumbs down.

Questions were even asked in the House of Commons, but nothing would change Health & Safety’s view

In the end a simple solution was found..

As the boxes came up from London they were piled up in a large building on the surface, in the position Janet wanted them underground.

The pile of boxes was then moved underground and stacked in exactly the same way.

Nowadays, anybody can work underground, but they must have training and be certified for such work.

Crossrail thought the number of certified underground workers might not be enough, so they set up the Tunnelling and Underground Construction Academy (TUCA) at Ilford. This article on the Crossrail web site is entitled  A Legacy To The Construction Industry.

Some points about TUCA.

  • It is now part of Transport for London.
  • It was funded by Crossrail and the Skills Funding Agency.
  • TUCA is Europe’s only specialist soft-ground tunnelling training facility.

I wrote about TUCA in Open House – TUCA, after a visit in 2012.

I was told on my visit, that the Swiss have a similar facility for rock tunnelling and that there were plans for both academies to work together.

Trainees from all over the world would get training in an exotic Swiss mountain and then go on to enjoy the wonders of Ilford.

But at least they’ll be safe workers for all types of tunnelling.

I do wonder if some of the Crossrail delays has been caused by a lack of properly trained underground workers, as now the tunnelling is completed, many have moved on to the next project.

Thames Tideway Scheme

The Thames Tideway Scheme is a £4billion scheme to build a massive sewer under the Thames to clean up the river.

Many Crossrail engineers, tunnellers and workers are now working on the new scheme.

Brexit

Stuttgart 21 is one of numerous mega-projects in Europe.

Many of the workers on Crossrail were originally from Europe and now with the uncertainties of Brexit, some must be moving nearer home,to work on these large European projects.

Well-Paid Jobs In Sunnier Climes

Don’t underestimate, the effect of the Beast From The East last winter.

Skilled personnel have always gone to places like the Middle East to earn a good crust.

With Crossrail under pressure, how many of these key workers have gone to these places for the money?

Conclusion

I wouldn’t be surprised to find that a shortage of specialist workers is blamed for the delays.

In the BBC article, there is this quote

We are working around the clock with our supply chain and Transport for London to complete and commission the Elizabeth line.

Fairly bland, but does the supply chain include specialist suppliers and workers, which are under severe pressure from other projects to perform various works?

It’s probably true that there is only a finite pool of these companies, tradesmen and workers and at least some of the best will have been lured away.

Station Problems

In this article in the Architects Journal, which is entitled Crossrail Delayed Until Autumn 2019, this is said.

Crossrail then revealed in February that it had overspent its budget for the year to 30 March 2018 by £190 million.

At the time TfL said works at Whitechapel station, designed by BDP, and Farringdon station, designed by AHR, were completed later than expected, and there were delays to work at Weston Williamson’s Woolwich station and John McAslan + Partners’ Bond Street station.

I’ll look at Whitechapel station as an example.

You don’t need to be an expert to figure out that Whitechapel station is running late.

Look at all the blue hoardings.

  • I know this only shows what is visible to the public.
  • The Crossrail platforms deep underground could be ready.
  • The main entrance to the station is still shrouded in plastic.
  • The escalators to get down to Crossrail, will be between the two District/Metropolitan Line platforms.

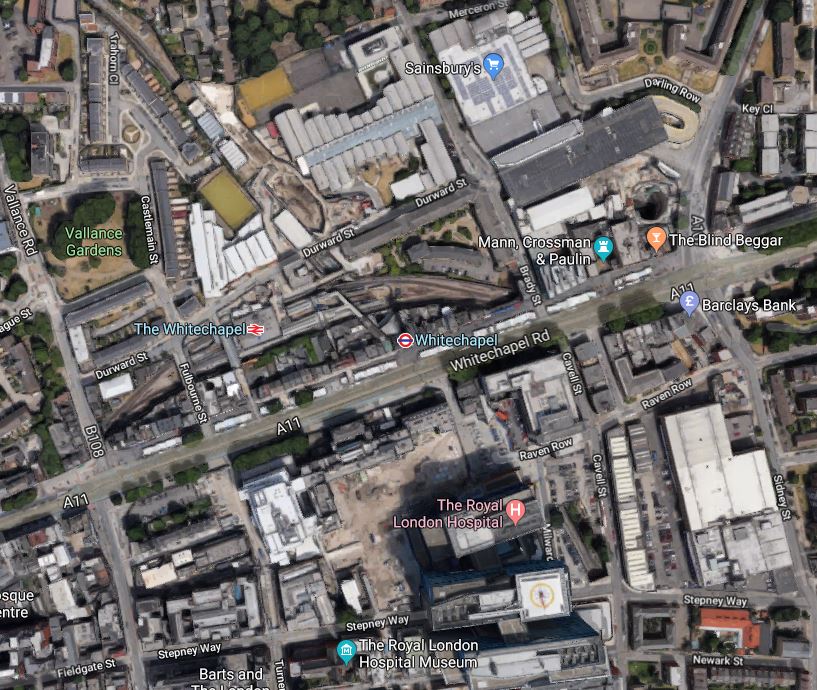

This Google Map shows the area of Whitechapel station.

Note how the site is hemmed in, by important buildings including a Sainsburys supermarket and Swanlea School.

See An Innovative Use Of The School Holidays, for an insight about how the builders of the station coped with the lack of space.

I also feel that Whitechapel is an incredibly complex station to build.

  • It is crossed by two important railways; the District/Metropolitan Line and the East London Line.
  • Innovative techniques from the coal mining industry had to be used to dig the escalator tunnel.
  • Whitechapel will be the station, where passengers change between the two Eastern branches.

I do wonder, whether a different design would have been easier to build.

For instance, could Sainsburys have been paid to shut their superstore and that site used to build the station?

But Crossrail has chosen a design and now they must build it.

The New Class 345 Trains

The new Class 345 trains for Crossrail are an almost totally new design called Aventra by Bombardier, that I believe has been specifically created to make the operation of Crossrail as efficient as possible.

The trains must have something about them, as since launch they have attracted five more substantial orders, from five different operators.

The introduction into service of the Class 345 trains,has been reasonably straightforward, but not without some issues.

But I do question, the launching of Aventra trains solely on a line as complex as Crossrail.

Would it have been easier to have built the Class 710 trains first and thoroughly debugged them on the Gospel Oak to Barking Line.

But then that electrification was late.

Four Types Of Signalling

Crossrail needs trains to have four different types of signalling.

CBTC – Communications-Based Train Control

ETCS – European Train Control System

AWS – Automatic Warning System

TPWS – Train Protection & Warning System

I know that as Crossrail runs on other lines with these signalling and going to a single system like ETCS would need to the changing of signalling systems on much of the railways in the South-East and the trains that use them.

It appears that there are problems for the trains running into Heathrow and one of the reasons for the Crossrail delayed opening, is to allow more time to test the trains and the signalling.

From my experience of writing complex software systems, where my software needed to interface with two operating systems, I know that you can never put too much time into testing complex systems.

So where is the dedicated test track, where trains can simulate the signalling of Crossrail routes, day in and day out?

I believe that not enough time and money was allocated to test this complex system.

Crossrail has found out the hard way.

Europe Has A Lack Of Train Test Tracks

A lot of European nations are ordering new trains and the UK is probably ordering more than most.

Reading the railway stories on the Internet, there are lots of stories about trains being brought into service late. And not just in the UK, but in Germany and Italy for example.

Crossrail identified that there was a need for a training academy for underground workers.

Did anybody do the calculations to make sure, there was enough test tracks for all the trains being built in Europe?

However, it does look as though Wales is coming to rescue Europe’s train makers, as I describe in £100m Rail Test Complex Plans For Neath Valley.

I suspect Crossrail wish this project had been completed a couple of years ago.

A Shortage Of Resources

For successful completion of projects on time and on budget, there must be enough resources.

I believe that, when the lateness and overspend on Crossrail is analysed, shortage of resources will be blamed.

  • Shortage of people and suppliers, that has not been helped by other projects taking advantage of new opportunities offered by Crossrail.
  • Shortage of space for work-sites at stations.
  • Shortage of places to fully test trains and signalling.

I suspect that the last will be the most serious.

Hugo Rifkind On A Late Crossrail

In an excellent article in today’s copy of The Times entitled Leavers Have A Cheek Trying To Block HS2, Hugo Rifkind says this about Crossrail.

You think we’ll remember, 50 years from now. that Crossrail took six months longer than expected?

Rubbish. London will rest on it like a spine and boggle that we ever managed without.

I think Rifkind is right.

Will Hutton

Will Hutton has written this article in the Guardian, which is entitled Don’t moan about Crossrail. Once Complete, It Will Be A Rare Triumph In Our public Realm.

He says this.

Let’s sing a different tune. Therailway line, more than 60 miles long, linking Reading and Heathrow in the west to Shenfield and Abbey Wood in the east – adding 10% to London’s commuter rail capacity – and set to carry around 200 million passengers a year, will be a fantastic achievement. Its 13-mile-long tunnels run more than 100ft under the capital’s streets, navigating everything from underground sewers to the deep foundations of skyscrapers with superb engineering aplomb. The longstanding reproach is that Britain can’t do grand projects. Crossrail, now christened the Elizabeth line, is proof that we can.

He then goes on to criticise the structure of the construction project, the salaries paid and the current Government.

But I suspect that in a few yeas time, Hutton, Rifkind and myself could have a quiet pint and say Crossrail got it right.

Current Developments That Will Help Bridge The Delay

It’s not as if, no new transport developments won’t happen in the time before Crossrail eventually opens in Autumn 2019.

Trains Providing More Capacity

These trains will be providing extra capacity.

  • New Class 717 trains will be running on the services to and from Moorgate station.
  • New Class 710 trains will be running on the Gospel Oak to Barking Line.
  • New Class 710 trains will be running on the Lea Valley Lines to Cheshunt, Chingford and Enfield Town stations.
  • New Class 710 trains will be running on the Watford DC Line.
  • Cascaded Class 378 trains and new Class 710 trains will be running extra services on the original circular service of the London Overground.
  • More Class 345 trains will be providing all of Crossrail’s services to Heathrow and Shenfield.
  • New Class 720 trains or something similar or older, will be providing four trains per hour (tph) between Stratford and Meridian Water stations.

Note that before the end of 2019, nearly a hundred new trains will be delivered.

New And Rebuilt Stations

There will be some new or rebuilt stations.

  • Acton Main Line
  • Forest Gate
  • Gidea Park
  • Hayes & Harlington
  • Manor Park
  • Maryland
  • Meridian Water
  • Northumberland Park
  • Tottenham Hale
  • West Drayton
  • West Ealing
  • West Hampstead

This list may contain other stations.

Underground Improvements

There will also be Underground improvements.

  • The Central Line Improvements Programme will increase capacity and reliability on the Central Line.
  • The Metropolitan Line is being upgraded with new signalling.
  • Up to ten Underground stations may be made step-free before the end of 2019.

The improvements to the Central and Metropolitan Lines, through Central London will compensate for the delaying of Crossrail’s core tunnel.

A Few Questions

I have to ask questions.

Will The High Meads Loop Be Used?

This would provide an excellent interchange between the following services.

  • Local services to Hertford East and Bishops Stortford stations,  including the new STAR service, along the West Anglia Main Line.
  • Stansted Express and Cambridge services to and from Stratford.
  • Fast Greater Anglia services to Chelmsford, Colchester, Southend and further, along the Great Eastern Main Line.
  • Crossrail services between Liverpool Street and Shenfield.
  • Central Line services.

There is also only a short, but tortuous walk to the Jubilee Line for London Bridge and Waterloo stations and Central London.

Based on the experience of the Wirral Loop under Liverpool, which handles sixteen tph, I believe that the High Meads Loop could handle a substantial number of trains, that instead of using the crowded lines to Liverpool Street station, would use the new uncrowded route from Tottenham Hale to Stratford via Lea Bridge station.

Moving services to Stratford from Liverpool Street would also free up platforms at the major terminus, which could be used to provide extra services on the Great Eastern Main Line.

The extra capacity might also enable the lengthening of the Crossrail platforms at Liverpool Street to be extended, so they could take full-length Class 345 trains.

No new extra infrastructure would be required at Stratford, although in future, a platform to connect the loop to Stratford International station would be nice.

I will be very surprised if the High Meads Loop is not used creatively in the future.

Will Some New Pedestrian Tunnels At Stations Like Liverpool Street And Paddington Be Opened?

I use Moorgate and Liverpool Street stations regularly.

There are blue walls everywhere, behind which the Crossrail infrastructure is hiding.

I do hope Crossrail and Transport for London are looking at the possibilities of using completed infrastructure to create new walking routes in stations to ease congestion.

Conclusion

Crossrail was designed to be opened in four phases over two years.

I am drawn to the position, that because of various resource shortages and the testing of trains, perhaps the project could have been arranged as perhaps a series of smaller projects delivered over a longer period of time.
